This page is the exhaustive worked-example companion to the parent note . There, we derived why the learning rate η must shrink. Here, we hit every kind of question a schedule can throw at you — every phase, every degenerate input, every limiting value — one fully worked example per case.
η ( t ) " even is, in one breath
Picture a knob labelled "step size". Training runs for many steps, counted by t = 0 , 1 , 2 , … . A schedule is just a recipe that turns the dial as t grows. Every example below is: "given the recipe and a value of t , read the dial." Nothing more mysterious than reading a clock.
Prerequisites we lean on: Stochastic Gradient Descent , Adam and Adaptive Optimizers , Robbins-Monro Stochastic Approximation , Loss Landscapes and Minima .
Every schedule question falls into one of these case classes . The whole point of this page is to leave no cell untouched.
Cell
Case class
What makes it tricky
Covered by
A
Discrete drop, mid-interval
floor function jumps
Ex 1
B
Discrete drop, exact boundary
is t = s before or after the drop?
Ex 2
C
Smooth decay, endpoints (t = 0 , t = T )
must return η m a x , η m i n exactly
Ex 3
D
Smooth decay, non-symmetric interior point
the "not linear" trap
Ex 4
E
Warmup phase (t ≤ T w )
ramp up , not down
Ex 5
F
Warmup → decay handoff (the join t = T w )
continuity: two formulas must agree
Ex 6
G
Degenerate / zero inputs (η m i n = 0 , t = 0 , γ = 1 )
limits and "no-op" schedules
Ex 7
H
Limiting behaviour (t → ∞ )
does ∑ η diverge? does η → 0 ?
Ex 8
I
Real-world word problem (units: epoch vs step)
the unit-conversion trap
Ex 9
J
Exam twist (solve for t , not for η )
invert the schedule
Ex 10
We use these symbols throughout — all defined in the parent, restated here so nothing is assumed:
Definition Symbols, in plain words
t — the time counter (an integer: step number or epoch number). Starts at 0 .
η ( t ) — the learning rate at time t : the size of the step the optimizer takes.
η 0 , η m a x — the starting / peak learning rate.
η m i n — the floor learning rate a smooth schedule decays toward.
γ (gamma) — the drop factor in step decay, 0 < γ < 1 (e.g. 0.5 = "halve it").
s — how many epochs between drops.
⌊ x ⌋ — the floor : round x down to the nearest whole number. ⌊ 2.9 ⌋ = 2 .
T — total number of steps a cosine schedule sweeps over.
T w — the number of warmup steps.
The full schedule we return to again and again:

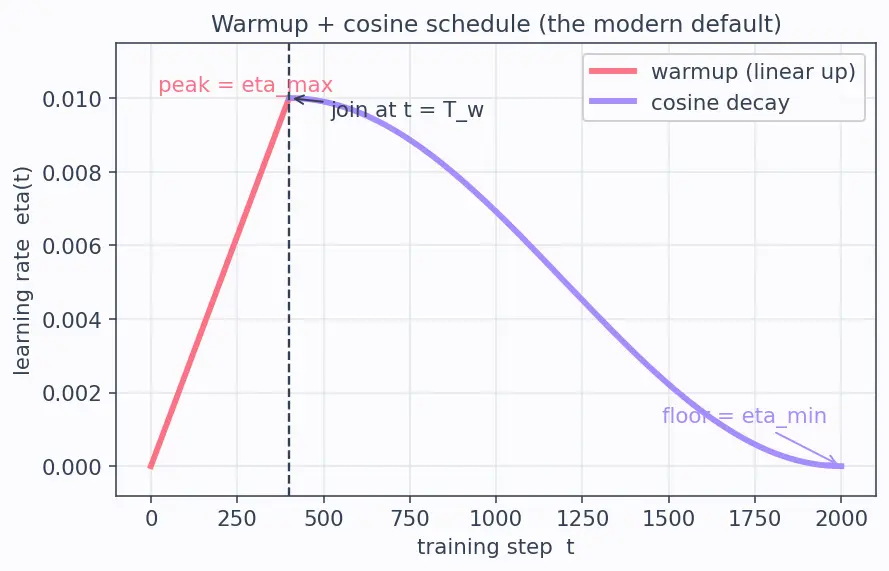

That figure shows the warmup + cosine shape. Follow the coral warmup line rising, the join at t = T w , then the lavender cosine curve settling. Every example below lives somewhere on a curve like this.
Worked example Ex 1 · Step decay, read mid-plateau
η 0 = 0.1 , γ = 0.5 , drop every s = 30 epochs. Find η at epoch t = 65 .
Forecast: two full drops have happened by epoch 65 (at 30 and 60), so guess — is η closer to 0.05 , 0.025 , or 0.0125 ?
Count the drops: ⌊ 65/30 ⌋ = ⌊ 2.1 6 ⌋ = 2 .
Why this step? The floor counts how many complete blocks of s epochs have elapsed — i.e. how many times the dial has been turned down.
Apply the factor twice: η = η 0 γ 2 = 0.1 × 0. 5 2 = 0.1 × 0.25 = 0.025 .
Why this step? Each drop multiplies by γ ; two drops means γ × γ = γ 2 .
Verify: epoch 65 sits inside the third plateau [ 60 , 90 ) , on which η is flat at 0.025 . Bounds check: 0 < 0.025 < η 0 . ✔ Answer: 0.025 .
Worked example Ex 2 · Step decay
on the drop epoch
Same schedule (η 0 = 0.1 , γ = 0.5 , s = 30 ). Find η at exactly t = 60 .
Forecast: epoch 60 is the moment of the second drop. Does the drop happen at 60, or does 60 still enjoy the old rate?
Evaluate the floor at the boundary: ⌊ 60/30 ⌋ = ⌊ 2.0 ⌋ = 2 .
Why this step? The formula η 0 γ ⌊ t / s ⌋ is exact; at t = 60 the ratio is a whole number 2 , so the floor gives 2 , not 1 . The drop is applied at the boundary.
η = 0.1 × 0. 5 2 = 0.025 .
Verify: compare t = 59 : ⌊ 59/30 ⌋ = 1 ⇒ η = 0.05 . So between epoch 59 and 60 the rate steps 0.05 → 0.025 — the plateaus are half-open intervals [ 60 , 90 ) . Boundary belongs to the new, lower plateau. ✔ Answer at t = 60 : 0.025 .
Common mistake Off-by-one at boundaries
It's tempting to say "the drop happens after epoch 60, so epoch 60 still has 0.05 ." The formula says otherwise: ⌊ 60/30 ⌋ = 2 . Always trust the floor, not your gut.
Worked example Ex 3 · Cosine annealing at both ends
η m a x = 0.01 , η m i n = 0 , T = 1000 . Find η at t = 0 and at t = T = 1000 .
Forecast: an ideal schedule should start hot and end cold . Predict the two endpoint values before computing.
Recall the cosine formula (parent note): η ( t ) = η m i n + 2 1 ( η m a x − η m i n ) ( 1 + cos T π t ) .
At t = 0 : cos ( 0 ) = 1 , so η = 0 + 2 1 ( 0.01 ) ( 1 + 1 ) = 2 1 ( 0.01 ) ( 2 ) = 0.01 .
Why this step? Plugging t = 0 makes the cosine argument 0 ; cos 0 = 1 pushes the bracket to its maximum value 2 , recovering η m a x .
At t = T = 1000 : cos ( π ) = − 1 , so η = 0 + 2 1 ( 0.01 ) ( 1 − 1 ) = 0 .
Why this step? At the end the argument is π ; cos π = − 1 collapses the bracket to 0 , recovering η m i n .
Verify: the schedule spans exactly [ η m i n , η m a x ] = [ 0 , 0.01 ] as t goes 0 → T . Both endpoints land on their intended targets. ✔ Answers: 0.01 and 0 .
Worked example Ex 4 · Cosine at a quarter (the "not linear" trap)
η m a x = 0.1 , η m i n = 0 , T = 100 . Find η at t = 25 . Is it above or below 0.05 ?
Forecast: a linear schedule would give 0.075 at the quarter point (dropped 25% of the way). A midpoint-guess person says 0.05 . Cosine says…?
Compute the argument: T π t = 100 π ⋅ 25 = 4 π .
Why this step? The cosine's input is the fraction of the journey t / T = 0.25 times π .
cos ( π /4 ) = 2 2 ≈ 0.7071 .
η = 0 + 2 1 ( 0.1 ) ( 1 + 0.7071 ) = 0.05 × 1.7071 = 0.08536 .
Why this step? Because cos is still high early on, the bracket is well above 1 , keeping η high.
Verify: 0.08536 > 0.075 (linear) > 0.05 (midpoint guess). Cosine stays high early , exactly as its flat start promises. Look at the landscape : this keeps the ball travelling fast through the early basin. ✔ Answer: 0.0854 (above 0.05 ).

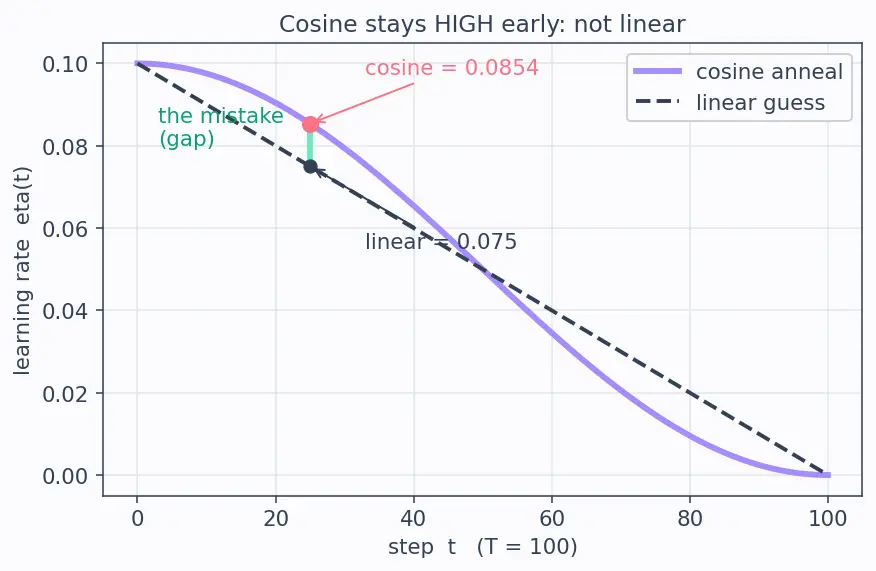

The figure overlays the cosine curve (lavender) against the linear guess (dashed slate). At t = 25 the vertical gap is the mistake you'd make by assuming linearity.
Worked example Ex 5 · Inside warmup
Transformer: η m a x = 5 × 1 0 − 4 , warmup T w = 4000 steps (linear). Find η at step t = 1000 .
Forecast: we are one-quarter of the way up the warmup ramp. Guess before computing.
Confirm the phase: 1000 < 4000 , so we are in warmup , using η ( t ) = η m a x ⋅ T w t .
Why this step? Warmup and decay use different formulas ; you must first decide which regime t lives in.
η = 5 × 1 0 − 4 ⋅ 4000 1000 = 5 × 1 0 − 4 × 0.25 = 1.25 × 1 0 − 4 .
Why this step? The ramp is a straight line from 0 at t = 0 to η m a x at t = T w ; at a quarter of the way, we're at a quarter of the peak.
Verify: 0 < 1.25 × 1 0 − 4 < η m a x = 5 × 1 0 − 4 . ✔ Why warmup up, not down? At step 0 Adam's second-moment estimate v ^ ≈ 0 , so effective steps η / v ^ could explode; a small η keeps them tame. Answer: 1.25 × 1 0 − 4 .
Worked example Ex 6 · The join must be continuous
Warmup for T w = 4000 up to η m a x = 5 × 1 0 − 4 , then 1/ t -style decay η ( t ) = η m a x T w / t afterwards. Evaluate at t = 4000 from both formulas. Do they agree?
Forecast: if the schedule has a jump at the join, training gets a jolt. A well-built schedule is continuous. Predict whether the two sides match.
Warmup formula at t = T w : η = η m a x ⋅ 4000 4000 = η m a x = 5 × 1 0 − 4 .
Why this step? At the top of the ramp the fraction t / T w = 1 , giving the full peak.
Decay formula at t = T w : η = η m a x 4000/4000 = η m a x 1 = 5 × 1 0 − 4 .
Why this step? The decay is deliberately written so T w / t = 1 exactly at the handoff.
Verify: both give 5 × 1 0 − 4 — the schedule is continuous at t = T w ; no jump. This is the famous Transformer schedule (warmup then inverse-square-root). ✔ Answer: 5 × 1 0 − 4 from both sides.

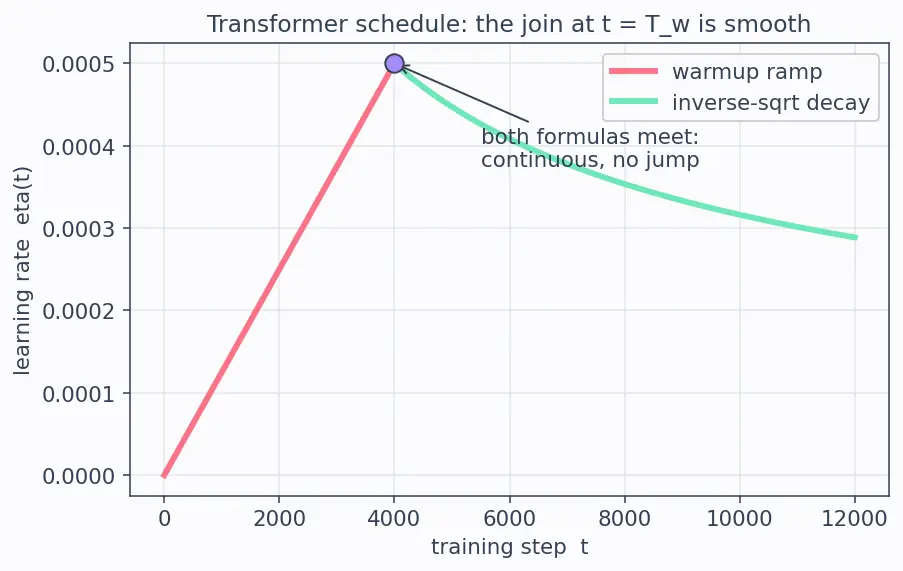

The figure zooms on the join: coral warmup and mint decay meet at one point — no discontinuity. See Warm Restarts (SGDR) for schedules that deliberately jump instead.
Worked example Ex 7 · Three degenerate schedules
Evaluate each edge case.
(a) Step decay with γ = 1 : what is η ( t ) for all t ?
(b) Cosine with η m a x = η m i n = 0.003 : what is η ( t ) ?
(c) Warmup at exactly t = 0 : what is η ( 0 ) ?
Forecast: each of these "breaks" a knob. Guess which ones flatten into a constant schedule.
(a) η ( t ) = η 0 ⋅ 1 ⌊ t / s ⌋ = η 0 ⋅ 1 = η 0 for every t .
Why? γ = 1 means "drop by a factor of 1" = don't drop at all. Step decay degenerates to a constant schedule — and by the parent's noise-floor result, leaves residual variance V ∝ η 0 > 0 .
(b) η = η m i n + 2 1 ( η m a x − η m i n ) ( 1 + cos ⋯ ) = 0.003 + 2 1 ( 0 ) ( ⋯ ) = 0.003 .
Why? When max = min, the amplitude ( η m a x − η m i n ) = 0 kills the cosine term. Flat line at 0.003 .
(c) η ( 0 ) = η m a x ⋅ T w 0 = 0 .
Why? The warmup ramp genuinely starts from zero — the very first step takes essentially no step. That's the whole point.
Verify: (a) and (b) both collapse to constants (η 0 and 0.003 ); (c) gives 0 . All three are consistent with the formulas at their degenerate inputs. ✔ Answers: η 0 , 0.003 , 0 .
Worked example Ex 8 · Does
1/ t decay satisfy Robbins–Monro?
Schedule η ( t ) = 1 + λ t η 0 with η 0 = 0.1 , λ = 0.01 . (i) What is lim t → ∞ η ( t ) ? (ii) Does ∑ t η ( t ) diverge? (iii) Does ∑ t η ( t ) 2 converge?
Forecast: the Robbins–Monro conditions demand ∑ η = ∞ and ∑ η 2 < ∞ . Predict whether this schedule passes both before computing.
(i) As t → ∞ , the denominator 1 + λ t → ∞ , so η ( t ) → 0 .
Why this step? We must send η → 0 to kill the noise floor V ∝ η (parent derivation). This schedule does.
(ii) For large t , η ( t ) ≈ λ t η 0 ∝ t 1 . The harmonic series ∑ 1/ t diverges .
Why this step? Divergence means the total distance travellable is infinite — the optimizer can reach any minimum, however far. ✔
(iii) η ( t ) 2 ≈ t 2 ( η 0 / λ ) 2 ∝ t 2 1 . The series ∑ 1/ t 2 = π 2 /6 converges .
Why this step? Convergence means accumulated noise is finite — the jitter dies out. ✔
Verify: η → 0 ✔, ∑ η = ∞ ✔, ∑ η 2 < ∞ ✔. This is exactly why 1/ t is the classical Robbins–Monro schedule. (By contrast, constant η fails: ∑ η 2 = ∞ .) passes both .
Worked example Ex 9 · Epochs vs steps
A dataset has 50 , 000 images, batch size 250 , so 200 mini-batch steps per epoch. You want step decay that halves η every 30 epochs (η 0 = 0.1 ). Your framework schedules in steps , not epochs. What s steps do you pass? And what is η at step t = 12000 ?
Forecast: if you naively pass s = 30 (thinking steps), you'll decay 200 × too fast. Predict the correct s and where step 12000 lands.
Convert the drop period: s steps = 30 epochs × 200 epoch steps = 6000 steps.
Why this step? The framework counts t in steps , so the drop interval must be expressed in the same unit . Mixing units is the classic bug the parent warns about.
Step 12000 in epochs: 12000/200 = 60 epochs — the second drop.
Drops so far: ⌊ 12000/6000 ⌋ = 2 , so η = 0.1 × 0. 5 2 = 0.025 .
Why this step? Same floor logic as Ex 1, now in step-units.
Verify: cross-check in epoch-units: ⌊ 60/30 ⌋ = 2 ⇒ 0.1 × 0.25 = 0.025 . Both unit systems agree because we converted correctly . Had we wrongly used s = 30 steps, we'd get ⌊ 12000/30 ⌋ = 400 drops → η = 0.1 × 0. 5 400 ≈ 0 — absurd. ✔ Answers: s steps = 6000 , η = 0.025 . See Batch Size and Learning Rate scaling for how batch size also affects η 0 itself.
Worked example Ex 10 · Solve
for the step , not for η
Exponential decay η ( t ) = η 0 e − λ t with η 0 = 0.1 , λ = 0.002 . At which step has η fallen to one-tenth of its start, η = 0.01 ?
Forecast: this is the half-life idea generalized to a "tenth-life". Guess the order of magnitude of t (hundreds? thousands?).
Set up the equation: 0.01 = 0.1 e − 0.002 t .
Why this step? We're told η and asked for t — invert the schedule.
Divide by 0.1 : e − 0.002 t = 0.1 .
Why this step? Isolate the exponential.
Take natural log (the tool that undoes e ⋅ ): − 0.002 t = ln ( 0.1 ) = − ln 10 ≈ − 2.3026 .
Why this tool? ln is precisely the inverse of e x ; it's the only clean way to bring t down from the exponent.
Solve: t = 0.002 2.3026 = 1151.3 , round up to t = 1152 .
Why round up? Steps are integers; at t = 1151 we're a hair above 0.01 , at t = 1152 just below.
Verify: plug back η ( 1151.3 ) = 0.1 e − 0.002 × 1151.3 = 0.1 e − 2.3026 = 0.1 × 0.1 = 0.01 ✔. (Half-life sanity: t 1/2 = ln 2/ λ = 0.6931/0.002 ≈ 347 steps; a "tenth-life" is log 2 10 ≈ 3.32 half-lives ≈ 1152 steps ✔.) Answer: t ≈ 1151 (step 1152 first below).
Recall Which cells collapse to a constant schedule, and why?
Step decay with γ = 1 (Ex 7a) and cosine with η m a x = η m i n (Ex 7b). ::: Both zero out the "amount of change" — γ k = 1 for all k , and amplitude ( η m a x − η m i n ) = 0 — so η never moves. By the parent's noise-floor result these leave V ∝ η > 0 .
Recall At a step-decay boundary
t = s , has the drop happened?
Yes. ::: ⌊ s / s ⌋ = 1 , so η = η 0 γ 1 ; plateaus are half-open [ k s , ( k + 1 ) s ) and the boundary belongs to the new, lower plateau.
Recall Why does the cosine value at the quarter-point exceed the linear guess?
Because cosine stays flat/high early. ::: cos ( π /4 ) ≈ 0.707 , so the bracket ( 1 + cos ) ≈ 1.707 keeps η near 85% of range, versus 75% for a straight line.
Recall Which tool inverts an exponential-decay schedule to solve for
t ?
The natural logarithm ln . ::: ln is the exact inverse of e x , bringing t down out of the exponent.
