Intuition The one core idea
Training a network means repeatedly nudging its numbers downhill on a "badness" surface, and the learning rate is simply how big each nudge is . A learning rate schedule is the plan for shrinking those nudges over time — big early to travel fast, tiny later to settle gently — and everything on the parent page is built from that single picture.
This page assumes nothing . If the parent note used a symbol, we define it here from scratch: plain words → the picture it stands for → why the topic needs it. Read top to bottom; each block only uses ideas already built above.
Intuition The valley picture

A trained network is just a big list of numbers (called parameters ). For any choice of those numbers, we can measure how wrong the network is on our data — one single "badness" number. If you imagine plotting badness against the parameters, you get a bumpy surface with valleys . Training = rolling a ball to the bottom of a valley.
Look at the surface above. The height is badness. The ball is our current network. We want to reach the lowest point. Every symbol below is a piece of this one picture. See Loss Landscapes and Minima for the surface itself.
θ (theta)
θ is the whole collection of numbers inside the network — every weight and bias — bundled together into one object. Think of it as the coordinates of the ball on the valley floor-map.
Plain words: "the current setting of all the dials in the network."
The picture: a single dot on the ground-map of the valley. Move the dot → you've changed the network.
Why the topic needs it: the schedule's whole job is to control how far the dot moves each step , so we must first have a name for the dot.
θ is one number."
Why it feels right: we write it with one letter.
Why it's wrong: it's usually millions of numbers at once. We use one letter as shorthand for the entire list, exactly like calling a whole shopping list "the list."
L ( θ ) — the loss
L is a machine: feed it a setting θ , it returns one number = how wrong the network is with those settings. "Loss" is just a technical word for badness .
The picture: the height of the surface directly above the ball's position θ .
Why we need it: without a height to descend, "downhill" has no meaning. The loss defines which way is down.
L ( θ ) = one badness number for the setting θ
Lower L = better network. The lowest reachable point is a minimum (see Loss Landscapes and Minima ).
Here a genuine math tool enters. We must justify it.
gradient and not just L
Knowing your height L doesn't tell you which way is downhill. We need something that points the steepest uphill direction at your feet — then we walk the opposite way. That "steepest-uphill arrow" is exactly the gradient .
∇ θ L

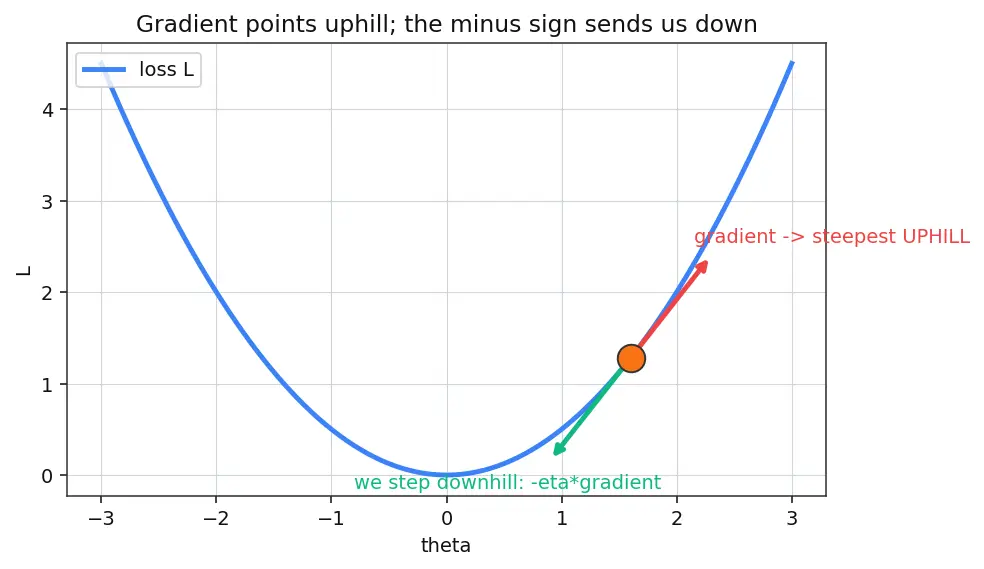

The gradient (symbol ∇ , called "nabla" or "del") is an arrow that, at the ball's location, points in the direction where the loss L increases fastest . Its length says how steep the slope is.
Plain words: "the steepest-uphill arrow at your current spot."
The picture: an arrow lying flat on the ground-map, pointing toward higher ground.
Why the topic needs it: to go down we step in the opposite direction, − ∇ θ L . That minus sign is why the update formula subtracts.
Common mistake "The gradient points downhill."
Why it feels right: we're descending, so surely it points where we go.
Why it's wrong: by definition it points uphill (steepest increase). We deliberately negate it. Miss the minus and the ball climbs out of the valley.
The subscript θ in ∇ θ just says "the arrow is measured with respect to changing θ " — i.e. "steepest direction in dial-space."
η (eta) — the learning rate
η is a positive number that controls how far the ball moves along the downhill direction each step. Big η = long strides; small η = baby steps.
The picture: the length of each footstep the ball takes downhill.
Why we need it: the gradient only gives a direction and a raw steepness; η converts that into an actual distance moved . Everything on the parent page is about choosing η well.
Now we can read the master update, one symbol at a time:
t — the training step
t counts how many updates we've done : t = 0 at the start, t = 1 after the first nudge, and so on.
The picture: a frame number in the movie of the ball rolling down.
Why the topic needs it: a schedule means η changes as t grows — written η ( t ) . Without a clock there is nothing to schedule against.
step and epoch .
One step = one parameter update (one mini-batch). One epoch = one full pass over all the data = many steps. They differ by (#batches per epoch). Mixing the units makes η decay far too fast or slow — always confirm what t counts. See Batch Size and Learning Rate scaling .

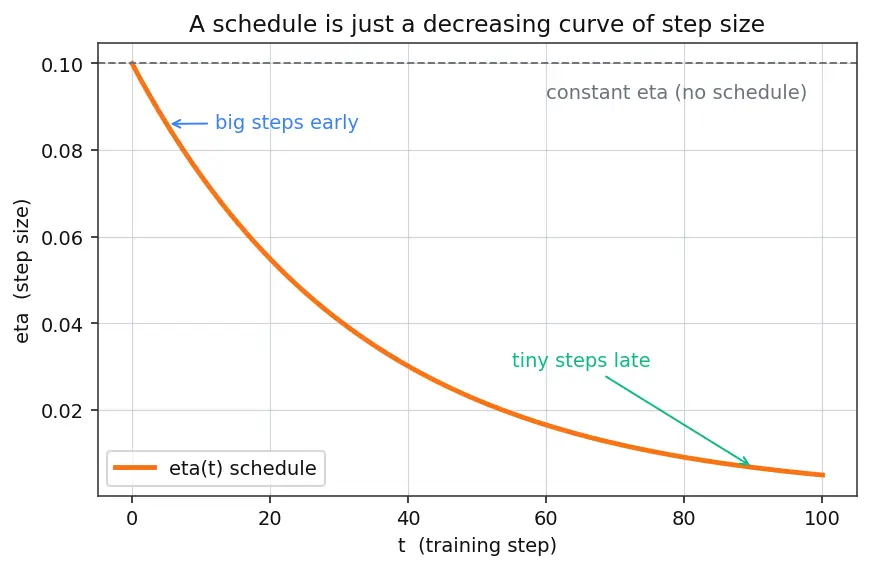

η ( t )
Instead of a fixed number, η ( t ) is a rule/curve : give it the step number t , it returns the step size to use right now.
The picture: a curve — time on the bottom axis, step size going up. The ball's stride follows this curve as it descends.
Why: the parent's whole thesis — big steps early, small steps late — is literally "make η ( t ) a decreasing curve."
The parent's derivation of why LR must decay needs three probability ideas. Build them now.
Intuition Why randomness appears at all
We don't compute the loss on all data at once — too slow. We use a small random mini-batch , so the gradient we get is the true one plus random wobble . That wobble is why the ball never sits perfectly still. This is the "stochastic" in Stochastic Gradient Descent .
ξ t (xi)
ξ t is the random error added to the gradient at step t because we used a small sample. It is zero-mean : on average it's nothing, but on any single step it jitters the arrow.
Var ( ⋅ ) and σ 2 (sigma-squared)
Variance measures how spread out a random quantity is — how wildly it jitters. σ 2 is the variance of the noise ξ t : a fixed number saying "how noisy each mini-batch gradient is."
The picture: a fuzzy cloud of possible ball-positions instead of one exact dot. Big variance = wide cloud.
Why the topic needs it: the parent shows the ball settles into a buzzing cloud of width V ∝ η . To shrink that cloud to a point you must shrink η — that is the mathematical reason schedules decay. See Robbins-Monro Stochastic Approximation .
a — curvature (how sharply the valley bends)
In the parent's simple model L ( θ ) = 2 1 a θ 2 , the number a says how steeply the walls rise near the bottom. Big a = narrow, steep valley; small a = wide, shallow bowl.
The picture: the tightness of the U-shape. A tight U bounces the ball back hard.
Why: it appears in the noise-floor formula and controls whether a given η overshoots.
The parent's schedule formulas use three notations. Define each and say why that tool .
⌊ x ⌋
⌊ x ⌋ = round down to the nearest whole number . ⌊ 2.9 ⌋ = 2 , ⌊ 65/30 ⌋ = ⌊ 2.16 ⌋ = 2 .
Why this tool: step decay drops η only at whole-number milestones; floor counts how many drops have happened , ignoring the fraction in between.
e − λ t
e ≈ 2.718 is a special constant; e − λ t is a curve that smoothly halves at a steady rate as t grows. λ (lambda) is the decay rate — bigger λ = faster shrink.
Why this tool: it gives a smooth version of step decay with no sudden jumps; its "half-life" is t 1/2 = ln 2/ λ .
cos ( ⋅ )

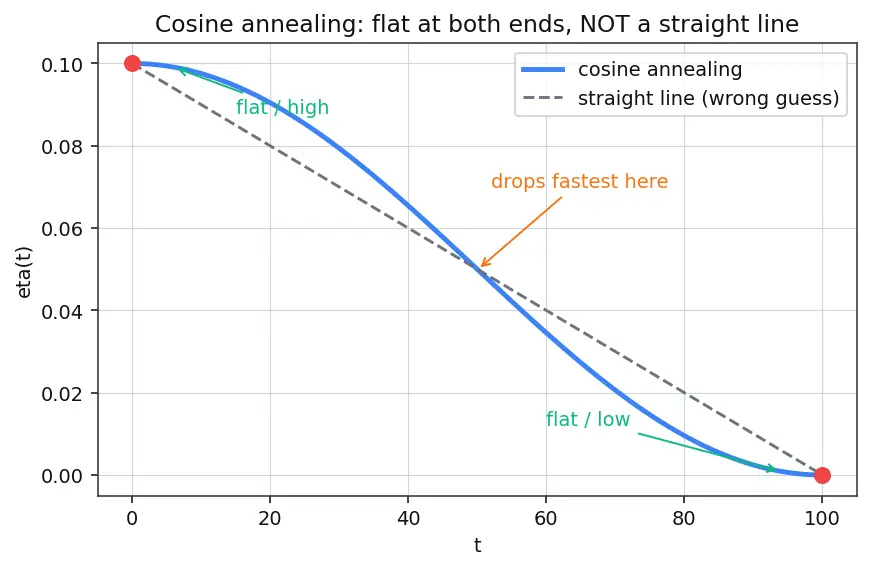

cos is a wave that starts at + 1 , dips to − 1 over half a turn, and is flat at both ends .
Why this tool: we want a schedule that stays high early , flat/gentle at both ends , and drops fastest in the middle — exactly cosine's shape. That flat-at-the-ends behaviour is the whole point of cosine annealing (and of Warm Restarts (SGDR) ).
Common mistake "Cosine annealing decays in a straight line."
Why it feels right: the middle of the arc looks straight.
Why it's wrong: near t = 0 and t = T the cosine is flat , so η barely changes there and plummets in the middle. Look at the figure: the ends are plateaus, not slopes.
Read top-down: parameters + loss give a gradient; gradient + learning rate give the update; the step counter turns a fixed η into a schedule η ( t ) ; the noise-and-curvature argument proves the schedule must decay; the floor/exp/cos tools build the actual curves. Everything converges on the parent topic. For choosing the numbers themselves, see Hyperparameter Tuning and Adam and Adaptive Optimizers .
Self-test: cover the right side and answer aloud.
What does θ stand for? The whole collection of network numbers — the ball's position on the valley map.
What single number does L ( θ ) give? How wrong (bad) the network is for setting θ ; the height of the surface.
Which direction does the gradient ∇ θ L point? Steepest uphill ; we step the opposite way to go down.
Why is there a minus sign in θ t + 1 = θ t − η ∇ L ? To turn the uphill gradient into a downhill move.
In words, what is the learning rate η ? The size/length of each step the ball takes downhill.
What does t count, and how does it differ from an epoch? t counts updates (steps); one epoch is a full data pass = many steps.
What is a schedule η ( t ) ? A rule/curve giving the step size to use at each step t .
What does variance / σ 2 measure here? How much the mini-batch gradient noise jitters — the width of the ball's buzzing cloud.
Why does V ∝ η force a decaying schedule? The residual jitter shrinks only as η → 0 , so we must decay η to settle at the true minimum.
What does ⌊ x ⌋ do and why is it in step decay? Rounds down; it counts how many whole drops have occurred.
Why cosine and not a straight line for annealing? Cosine is flat at both ends (high-then-gentle) and drops fastest mid-way — ideal travel-then-settle shape.
