This page drills the repayment decision from the parent note until every possible input has been walked. The one weapon we use over and over is the rule of thumb:

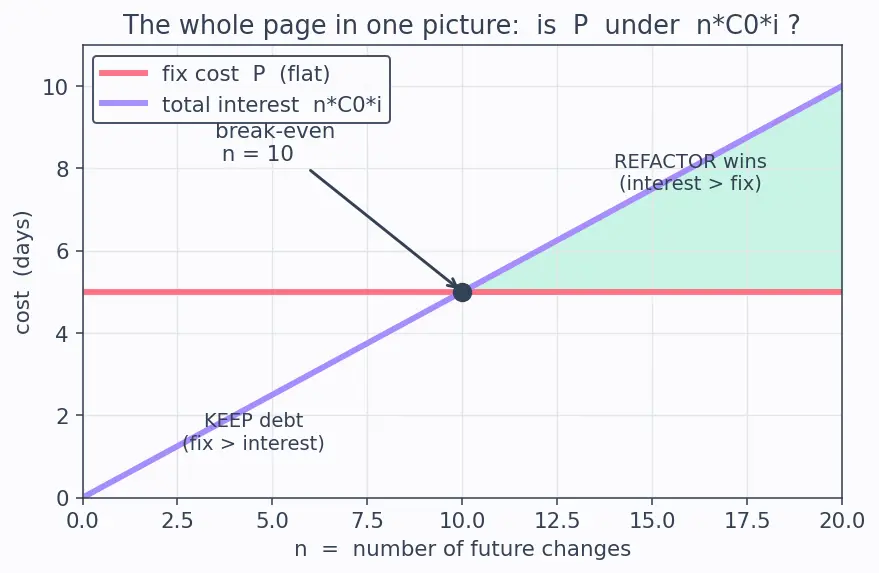

Everything below is just this one inequality, poked from every angle. The figure is the whole page in one picture — study it before reading on.
Read the figure carefully, because every example lands somewhere on it:
The flat coral line at height 5 is your one-time fix cost P . It is horizontal because P does not depend on how many changes come — you pay it once, whatever n is.
The rising lavender line is total interest n C 0 i . With C 0 = 2 and i = 0.25 it climbs by 0.5 days for every extra change, so it is a straight line through the origin with slope C 0 i .
The two lines cross at the black dot , n = 10 (that is Ex 3's break-even). Left of the dot the coral fix is dearer than the interest ⇒ keep the debt (labelled region). Right of the dot the lavender interest overtakes the fix ⇒ the mint-shaded "refactor wins" region.
Every worked example is really just the question "which side of that black dot am I on?"
n — is it always a whole number?
On the figure the lavender line is continuous , but n counts changes , so strictly n ∈ { 0 , 1 , 2 , … } . In real projects, though, you rarely know n exactly — you estimate it (e.g. "about 8 edits this year") or treat it as an expected value from probabilities (e.g. a 30% chance of one more change gives n = 0.3 ). That is why we happily read the line at non-integer points: n behaves like a continuous forecast , and the inequality P < n C 0 i works identically for fractional n . The only hard boundary is n ≥ 0 — you cannot have a negative number of changes.
Every case this topic can throw at you is one row here. Each worked example below is tagged with the cell it hits.
#
Case class
What makes it tricky
Example
A
Hot code (n large)
interest dwarfs the fix ⇒ repay
Ex 1
B
Cold / dead code (n → 0 )
interest ≈ 0 ⇒ never repay
Ex 2
C
The break-even point (P = n C 0 i )
tie — the indifference boundary
Ex 3
D
Zero interest (i = 0 )
clean-enough shortcut ⇒ never repay
Ex 4
E
Partial fix (fix lowers i , not to 0)
compare two interest streams
Ex 5
F
Compounding / debt spiral (i grows over time)
why "later" never comes
Ex 6
G
Real-world word problem (money + velocity)
translate business talk into P , n , C 0 , i
Ex 7
H
Exam twist (classify + decide together)
Fowler quadrant meets the inequality
Ex 8
Worked example Ex 1 · cell A
An authentication module is edited constantly. Clean change cost C 0 = 2 days. The mess adds interest i = 0.4 . You expect n = 15 edits this year. Proper fix P = 8 days.
Forecast: guess now — repay or keep? (Lots of edits… feel the lavender line climbing.)
Compute total interest n C 0 i = 15 × 2 × 0.4 = 12 days.
Why this step? This is the extra time wasted if you do nothing — the height of the lavender line at n = 15 .
Compare with the fix P = 8 . Is 8 < 12 ? Yes.
Why this step? The master inequality: repaying once (8) beats bleeding interest (12).
Decide: refactor now. Net saving = 12 − 8 = 4 days.
Verify: units check — everything is in days (i is unitless, so n C 0 i stays days). Sanity: high n ⇒ repay, matches the "hot code almost always repay" rule. ✓
Worked example Ex 2 · cell B
A migration script runs once , then is deleted. C 0 = 1 , i = 0.6 , n = 1 , fix cost P = 5 .
Forecast: the code barely gets touched — where does that push the lavender line?
Total interest = 1 × 1 × 0.6 = 0.6 days.
Why this step? With n = 1 the interest term is tiny — the lavender line is near the floor.
Compare: P = 5 vs 0.6 . Is 5 < 0.6 ? No.
Why this step? Fixing costs almost ten times the interest you'd ever pay.
Decide: keep the debt. It's prudent to leave it.
Verify: limiting sense — as n → 0 , interest → 0 , so P < 0 can never hold. Cold code is never worth refactoring. ✓
Worked example Ex 3 · cell C
C 0 = 2 , i = 0.25 , P = 5 . Question: at how many changes n does refactoring exactly break even?
Forecast: we're solving for the crossover — where coral and lavender lines meet.
Set the two costs equal: P = n C 0 i .
Why this step? Break-even means "fix cost equals interest cost" — neither choice wins.
Solve for n : n = C 0 i P = 2 × 0.25 5 = 0.5 5 = 10 .
Why this step? Rearranging the inequality to an equality gives the exact tipping point.
Interpret: below n = 10 keep the debt; above n = 10 refactor. At exactly 10 you're indifferent.
Verify: plug back — n C 0 i = 10 × 2 × 0.25 = 5 = P . ✓ This is the x -coordinate of the black dot where the lines cross in the figure.
Worked example Ex 4 · cell D
A helper function has an ugly name but is otherwise perfectly clear; the ugliness slows nobody down. i = 0 , C 0 = 3 , n = 40 , rename cost P = 0.5 .
Forecast: n is huge — does that force a repay?
Total interest = n C 0 i = 40 × 3 × 0 = 0 days.
Why this step? When i = 0 , the mess costs you nothing per change, no matter how many changes.
Compare: P = 0.5 vs 0 . Is 0.5 < 0 ? No.
Why this step? You cannot save time you were never losing.
Decide: don't spend the 0.5 day. (This is a code smell , but not debt until it actually slows change — see Code Smells .)
Verify: even with a giant n = 40 , interest is 0 . This proves n alone never justifies a fix — it's n C 0 i together, and any zero factor kills it. ✓
Real refactors often reduce interest without eliminating it. The inequality changes: compare doing nothing against fixing and then paying the smaller leftover interest.
Worked example Ex 5 · cell E
A tangled reporting layer has i now = 0.5 . A refactor costing P = 4 days would bring it down to i after = 0.1 (not zero — some complexity is essential). C 0 = 2 , n = 8 .
Forecast: the fix isn't perfect — does it still pay?
Cost if we do nothing: n C 0 i now = 8 × 2 × 0.5 = 8 days of interest.
Why this step? Baseline pain we're trying to beat.
Cost if we fix: pay P once, then interest at the lower rate:
P + n C 0 i after = 4 + ( 8 × 2 × 0.1 ) = 4 + 1.6 = 5.6 days .
Why this step? A partial fix does not remove all future cost — you must include the leftover i after .
Compare: 5.6 < 8 ? Yes ⇒ refactor. Net saving = 8 − 5.6 = 2.4 days.
Verify: the general rule for partial fixes is P + n C 0 i after < n C 0 i now , i.e. P < n C 0 ( i now − i after ) . Check: 4 < 8 × 2 × ( 0.5 − 0.1 ) = 6.4 . ✓ (Note this reduces to the master inequality when i after = 0 .)
Earlier cases assumed i is a fixed number. But debt often makes code worse over time — each unclean change piles on more mess, so i grows. This is the debt spiral .
Worked example Ex 6 · cell F
A module starts with i = 0.2 , but each edit raises it by 0.1 (edit 1 costs interest at 0.2 , edit 2 at 0.3 , edit 3 at 0.4 , …). C 0 = 1 , and we plan n = 5 edits. Fix cost P = 3 (freezes i at 0.2 afterward).
Forecast: a fixed -rate reading would say interest ≈ 5 × 1 × 0.2 = 1 < 3 , so keep it. Does compounding flip that?
Sum the growing interest (do nothing):
C 0 ∑ k = 1 5 ( 0.2 + 0.1 ( k − 1 ) ) = 1 × ( 0.2 + 0.3 + 0.4 + 0.5 + 0.6 ) = 2.0 days .
Why this step? Each edit's interest rate is higher than the last — you must add them one by one, not multiply by a single i .
Extend the horizon — spirals bite over many edits. Over n = 10 : rates 0.2 , 0.3 , … , 1.1 , sum = 6.5 days. Now P = 3 < 6.5 ⇒ refactor.
Why this step? With a fixed rate the interest line is straight; with compounding it curves upward , crossing P sooner than you'd guess.
Decide (the lesson): waiting makes the fix more attractive, not less. "We'll do it later" quietly grows the very cost you're deferring.
Verify: arithmetic-series sum ∑ k = 1 5 ( 0.2 + 0.1 ( k − 1 )) = 2.0 ✓ and for n = 10 the rates run 0.2 , … , 1.1 summing to 6.5 ✓. The n = 10 interest (6.5 ) exceeds P = 3 , confirming the flip.
Business people speak in velocity and money, not i and n . The skill is translation , and the trap is defining i correctly.
Worked example Ex 7 · cell G
A manager says: "Our team ships 10 story points/sprint on clean code, but this legacy service drops us to 8 points/sprint. A dedicated cleanup would take one full sprint. We'll be building on this service for 6 sprints." One sprint costs the company $20{,}000. Should we cleanup?
Forecast: losing 2 of 10 points feels small — but over 6 sprints?
Fix the units first. Let one clean sprint be our unit of work, and let C 0 = 1 sprint = the time to deliver one sprint's worth of clean output . In money that unit costs $20{,}000.
Why this step? C 0 must be a cost per unit of work , exactly as in the master inequality — not a velocity. We pin the unit down before defining i .
Define i from the definition, not by guesswork. The definition: i = fractional slowdown relative to clean cost . Clean code does one unit of work in 1 sprint; the messy service needs 8 10 = 1.25 sprints for the same unit. So the extra time is 1.25 − 1 = 0.25 sprints per unit, giving
i = clean time messy time − clean time = 1 1.25 − 1 = 0.25.
Why this step? This is the interest rate — the slowdown measured against the clean cost C 0 , matching Ex 1–6. (The tempting "8 10 − 8 = 0.25 " happens to give the same number here, but the principled route is time-per-unit, not points, so the definition never drifts.)
Set n = units of work over the horizon. We deliver one unit of clean work per sprint for 6 sprints, so n = 6 units, each with C 0 = 1 .
Why this step? n counts the future changes/work items the debt touches — here, six sprints of building on the service.
Apply the master inequality (in sprints, then dollars). Total interest = n C 0 i = 6 × 1 × 0.25 = 1.5 sprints. Fix cost P = 1 sprint.
Compare P = 1 < 1.5 ⇒ do the cleanup. In money: interest = 1.5 \times \ 20{,}000 = $30{,}000v s f i x $20{,}000; n e t s a v in g $10{,}000$.
Verify: consistent units throughout — i = 0.25 came straight from the definition (time-per-unit), n C 0 i = 1.5 sprints = \ 30{,}000, f i x = $20{,}000, s a v in g = $10{,}000$. ✓ See Agile Sprint Planning for reserving that cleanup sprint.
The trap: an exam gives you a Fowler quadrant and an ROI decision in one question. They are independent — a well-managed loan can still be worth keeping.
Worked example Ex 8 · cell H
"To hit a launch demo, the team knowingly ships without tests for a rarely-used admin panel, and files a ticket to add them. C 0 = 1 , i = 0.3 , n = 2 (panel is almost never touched), test-writing cost P = 3 . (a) Classify on Fowler's quadrant. (b) Should they pay it down next sprint?"
Forecast: a tracked, planned shortcut on cold code — two separate judgments.
(a) Classify. Chosen on purpose ⇒ Deliberate . Tracked with a ticket + plan ⇒ Prudent . So Deliberate–Prudent — the "healthy" quadrant.
Why this step? Classification is about intent and awareness , not about ROI. The ticket is what makes it prudent (see Software Maintainability , Unit Testing ).
(b) Decide with the inequality. Interest = n C 0 i = 2 × 1 × 0.3 = 0.6 days.
Why this step? Classification does not tell you whether to fix — the numbers do.
Compare: P = 3 vs 0.6 . Is 3 < 0.6 ? No ⇒ do NOT add the tests to cold code; the ticket can stay parked.
Why this step? Healthy debt on rarely-touched code is exactly the debt you keep . Classification "good" ≠ "must repay."
Verify: interest = 0.6 , P = 3 > 0.6 ⇒ keep. The two answers ("Deliberate–Prudent" and "don't repay") are consistent, not contradictory. ✓
Recall Quick self-test across all cells
Which factor being zero always kills a refactor case? ::: Any of i = 0 or n = 0 (or C 0 = 0 ) — the interest term n C 0 i collapses to zero, so no positive P can be smaller.
In the partial-fix case, what replaces the master inequality? ::: P < n C 0 ( i now − i after ) — you only "buy back" the reduction in interest.
Why does compounding make "do it later" a trap? ::: i grows with each unclean edit, so the interest line curves upward and crosses P sooner — waiting increases the cost you're deferring.
Does a Deliberate–Prudent classification mean you should repay? ::: No. Classification measures intent/awareness; the P < n C 0 i test decides repayment separately.
Can n be a fraction? ::: Yes — in practice n is an estimate or expected value (e.g. a 30% chance of one edit ⇒ n = 0.3 ); the inequality works for any n ≥ 0 .
Every case is the same line: is P under n C 0 i ? Find the four numbers, plug, compare. Translate business talk (velocity, dollars) into those four — pin the unit of work first, then define i as slowdown against clean cost.
See also: Refactoring , Test Driven Development , Coupling and Cohesion , Continuous Integration .
